7 Things Every BC Engineer Must Know About the EGBC Retaining Wall Guidelines

7 Things Every Bc Engineer Must Know About the Egbc Retaining Wall Guidelines - Structural Engineering Illustration
TL;DR Key takeaways before you dive in
  • Check the trigger matrix—height, surcharge, or public access can instantly move your wall into EGBC guideline territory.
  • Run the mandated risk assessment and 7-stage workflow so you know when independent review or field testing is compulsory.
  • Document the EoR duties, assurance statements, and deliverables up front to keep AHJ and client expectations aligned.

A retaining wall 3.0 m or higher needs an independent review before you issue drawings. EGBC’s retaining wall guidelines aren’t gentle suggestions. As Registrants of Engineers and Geoscientists BC, we’re required to have regard for them as the standard of practice.

The latest version of the EGBC Professional Practice Guidelines - Retaining Wall Design landed on October 10, 2024, and it’s aligned with the Professional Governance Act.

Here’s the essentials as a practical checklist of the key, actionable items.

1. When Do These Guidelines Apply?

Before you think about factors of safety, check that the guidelines apply at all.

Your project falls under these guidelines if you’re designing:

  • Cantilever Retaining Walls
  • Gravity and Semi-Gravity Walls
  • Segmental Block Gravity Walls
  • Mechanically Stabilized Earth (MSE) Walls
  • Stacked Rock Walls

This list covers most of the common walls we see every day. Knowing what’s not covered is just as critical for avoiding unnecessary work.

You can likely set the guidelines aside for:

  • Walls under 1.2 m high, unless their failure could hit a nearby structure or pose a life safety risk. This is a huge one for smaller landscaping projects.
  • Specific terraced walls where each tier is less than 1.2 m high, the overall slope is less than 45 degrees, and the step-back distance is greater than the wall height.
  • Specialized systems like soil nail walls, shotcrete and anchor walls, sheet pile walls, and temporary shoring.
  • Retaining structures that are part of a building’s excavation or foundation system under Part 4 of the British Columbia Building Code or Vancouver Building By-law. This distinction between a standalone structure and an integral part of a building highlights the difference between engineered precision and prescriptive paths in our codes.

Pro-Tip: Even if a formal design isn’t mandatory, the Authority Having Jurisdiction (AHJ) has the final say, and some have stricter requirements. Always check local bylaws.

2. Height, Impact, and What They Trigger

Table 3 in the guidelines connects wall height and potential impact to the level of design rigour required.

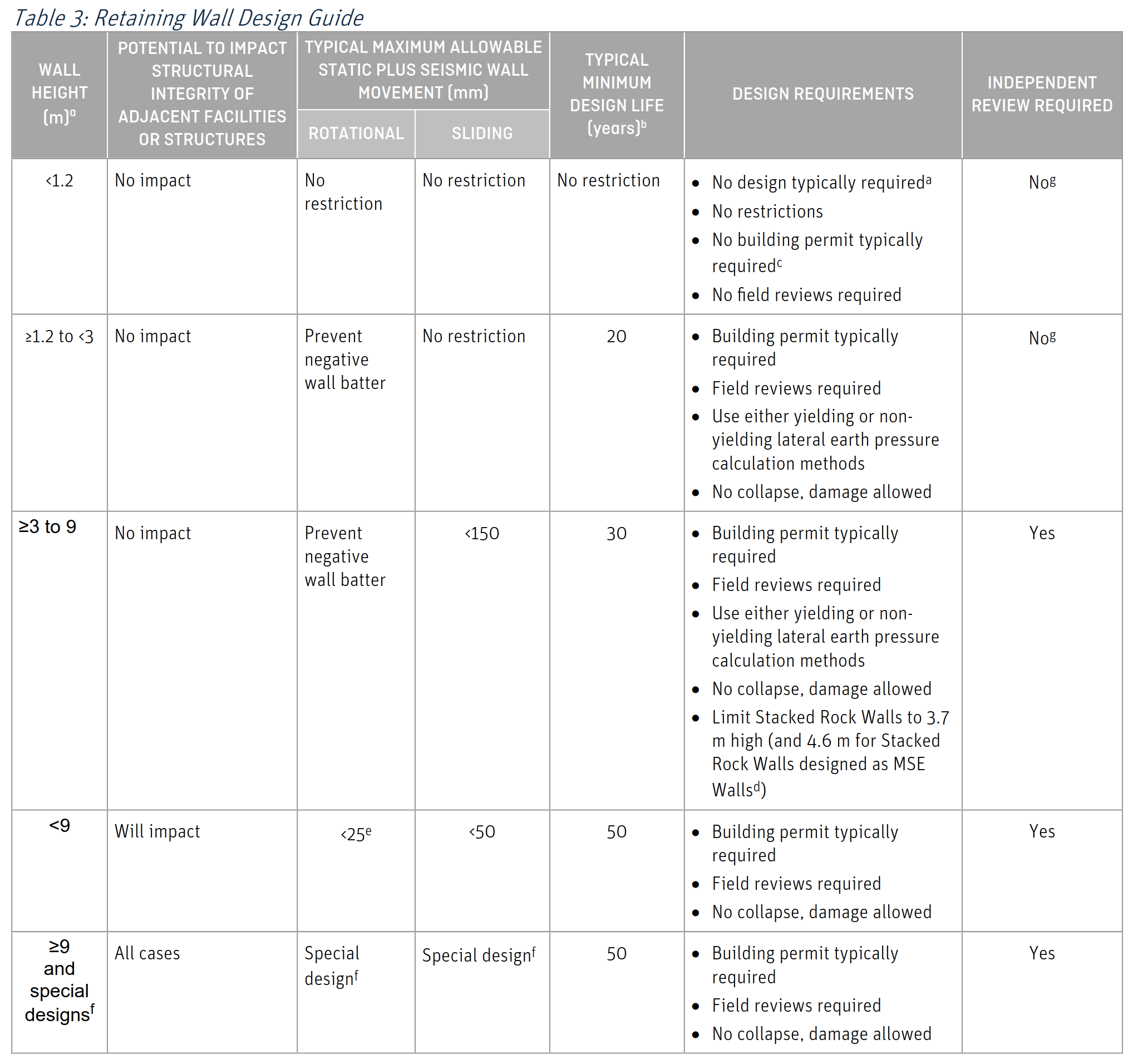

Table 3: Retaining Wall Design Guide

Source: EGBC Professional Practice Guidelines - Retaining Wall Design

Here’s the simplified breakdown:

  • The < 1.2 m Wall (No Impact): We’re in the clear. Typically no professional design, building permit, or field review is required.
  • The ≥1.2 m to <3 m Wall (No Impact): Now you’re on the hook. You’ll typically need a building permit and must conduct field reviews. You can use yielding or non-yielding earth pressure methods, but the wall must not collapse, even if some damage is acceptable under seismic loads.
  • The ≥3.0 m Wall: This is the big one. It’s the automatic trigger for a mandatory Independent Review of the design. The design life also bumps up to a minimum of 30 years.
  • Any Wall That Will Impact a Structure: If your wall could affect the structural integrity of an adjacent building or facility, the rules get much tighter, regardless of its height. You’re looking at stricter movement limits (<25 mm rotational, <50 mm sliding) and a minimum 50-year design life. Understanding how to manage these movement targets is a core part of navigating serviceability (SLS) in NBC 2020.

3. The Engineer of Record (EoR)

If you’re leading the design, you’re the Engineer of Record (EoR). The guidelines are clear about what this means. You are the one “who takes overall responsibility for all aspects of the design and field reviews for the Retaining Wall”.

Your role goes far beyond stamping the drawings. Your core duties include:

  • Determining if other specialists (like a dedicated geotechnical engineer or structural engineer) are needed.
  • Coordinating and integrating the work of everyone on the design team.
  • Authenticating and submitting the two key assurance statements to the owner.

4. The Mandatory Risk Assessment

A key change in our professional obligations is the emphasis on a formal, documented risk assessment. It is a mandatory process under the Bylaws, completed after the conceptual design but before the detailed design calculations.

The guidelines state the assessment must be used to answer two questions about the independent review process:

  1. Frequency of Review: Should there be a single independent review when the design is complete, or is the project complex enough to require multiple, staged reviews at different milestones?
  2. Reviewer’s Independence: Is it appropriate for the independent reviewer to be an engineer from your own firm? Or does the project’s risk profile demand a reviewer from a completely different firm, to ensure objectivity?

Why this matters: The risk assessment dictates the level of oversight. Its primary job is to determine if the design is “high-risk”. A high-risk designation automatically triggers the need for a documented independent review, regardless of the wall’s height. A 2-meter-high wall holding up the edge of a hospital parking lot could easily be deemed high-risk, while a 4-meter-high wall in a remote industrial yard might not be.

While the guidelines don’t provide a specific risk matrix, as the EoR, you’ll need to use your professional judgment to assess factors like:

  • Consequence of Failure: What would happen if the wall failed? Does it support critical infrastructure, a public road, or a building foundation? This ties into the same logic used when nailing Importance Categories in NBC 2020 for buildings.
  • Site Complexity: Are you dealing with challenging ground conditions like soft soils or high groundwater? Is the site in an area with high seismic hazard?
  • Design Complexity: Is it a standard, straightforward design, or does it involve unusual geometry, high surcharges, or terracing?
  • Project Scale: Taller walls (e.g., those approaching 9 meters) and longer walls naturally carry more inherent risk.

5. The Mandatory 7-Stage Project Workflow

The guidelines lay out a clear, seven-stage path for a retaining wall project.

  1. Initial Assessment
  2. Geotechnical Investigation
  3. Conceptual Design
  4. Risk Assessment
  5. Detailed Design
  6. Field Reviews and Design Changes
  7. Assurance Statements

6. Key Design & Performance Criteria

For detailed design, Table 4 is the key reference.

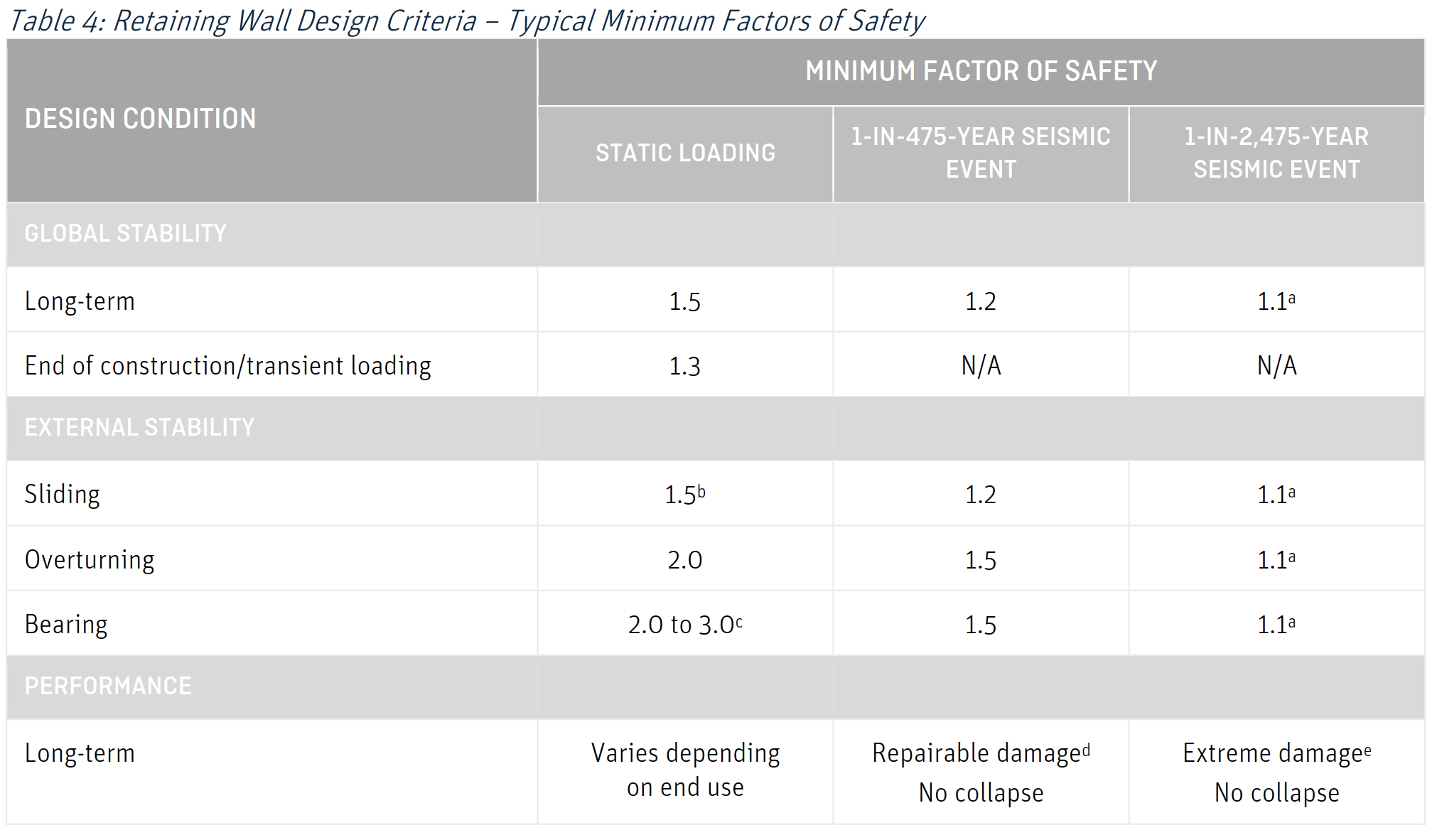

Table 4: Retaining Wall Design Guide

Source: EGBC Professional Practice Guidelines - Retaining Wall Design

Here are the minimum factors of safety you should have burned into your memory for static, long-term conditions:

  • Global Stability: F.S. ≥ 1.5
  • External Stability (Sliding): F.S. ≥ 1.5
  • External Stability (Overturning): F.S. ≥ 2.0
  • Bearing Capacity: F.S. ≥ 2.0 to 3.0

On the seismic front, the goal is “no collapse” during a design-level event. This performance target is a cornerstone of modern code philosophy, and a great way to understand the underlying principles is with an introduction to Performance-Based Design. For a detailed walkthrough of one common analytical method, our practical guide to seismic flexible retaining wall design is a great resource.

The factors of safety are naturally lower (e.g., 1.1 to 1.2 for a 1-in-475-year event). The understanding is that the wall may suffer repairable or even extreme damage. It must still remain standing to protect life safety.

And a friendly reminder on a topic that has bitten many engineers: drainage. Unless you’ve explicitly designed the wall to handle full hydrostatic pressure, you need an adequate drainage system. This means a free-draining backfill and a system to get water away from the wall for good.

7. Quality Management & Documentation

  • Documented Independent Review Let’s say it again: an independent review is required for all walls ≥3.0 m high, or any wall deemed high-risk by your documented risk assessment. The Bylaws define a retaining wall as a “structure,” so this applies to everyone. That MSE wall designed by a geotechnical engineer? It needs an independent review just like a concrete cantilever wall. The review must be done by a qualified professional not involved in the original design, and it must be completed before you issue drawings for construction.

  • Documented Field Reviews You, or a subordinate under your direct supervision, must perform and document field reviews. The goal is to “ascertain whether the construction or implementation of the work substantially complies in all material respects with the engineering concepts or intent”. This is your chance to catch errors before they get buried.

  • The Two Assurance Statements These are non-negotiable deliverables for the owner.

    1. Statement of Professional Design and Commitment for Field Review: You issue this before construction starts. It’s your professional commitment that the design is sound.
    2. Statement of Field Review and Compliance: You issue this after construction and all field reviews are done. It confirms the constructed wall substantially complies with your design.
  • Document Retention Don’t forget the paperwork. You’re required to retain complete project documentation for a minimum of ten years after project completion.

Wrapping It Up

If you remember nothing else, remember these three things:

  1. The 3.0-meter height is the primary trigger for a mandatory independent review.
  2. A documented risk assessment is a required step before detailed design begins.
  3. The two assurance statements are your formal, professional declarations of compliance at the beginning and end of construction.

Keep these three areas in your back pocket and the rest of the guidelines fall into place.
